Skip to main content
Resource planning

How to add and manage allocations in the People Timeline

The Timeline is an overview of who’s working on what and when.

Written By Lauri Eurén

Last updated 7 days ago

The Timeline view in Operating gives a clear, interactive overview of the allocation plans in the system. It’s the main workspace for adding, adjusting, and reviewing resource allocations across your team.

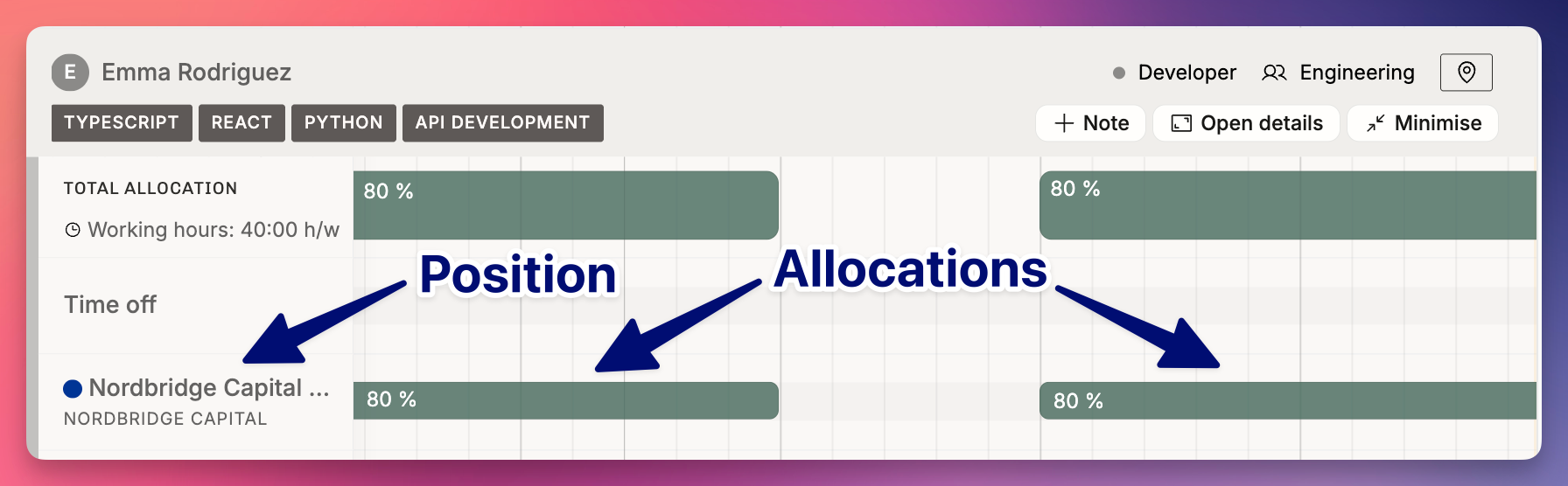

In Operating, work is organized into positions and allocations:

  • A position is a role someone holds in a project. A position has attributes like rate and (optionally) role or seniority.

  • An allocation is a specific amount of work assigned to that position for a given time period.

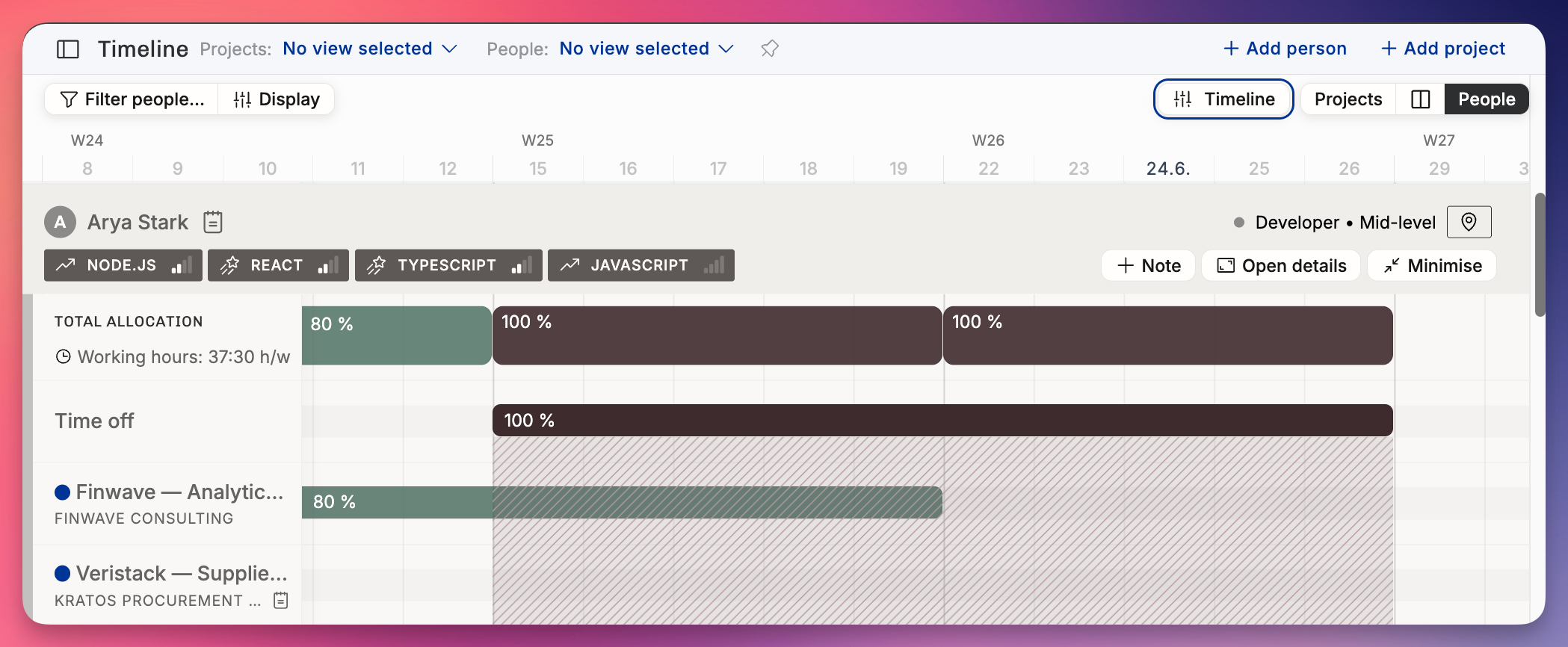

One position can have many allocations. For example: Lauri is a Project Manager on Project X (position). His allocations might be:

  • 100% for the first two weeks

  • 50% for the next week

  • A break (no allocation) for two days

  • 4 hours on one day the following week


What You See on the Timeline

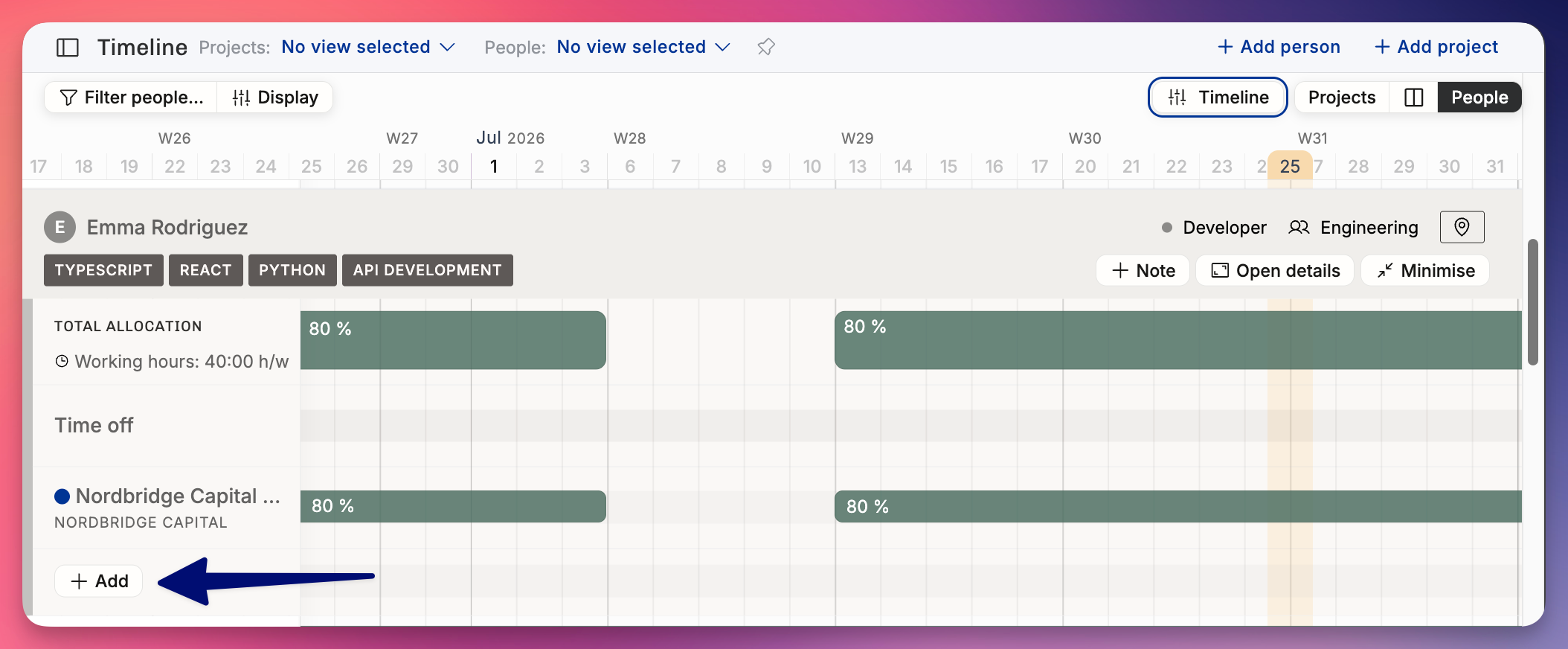

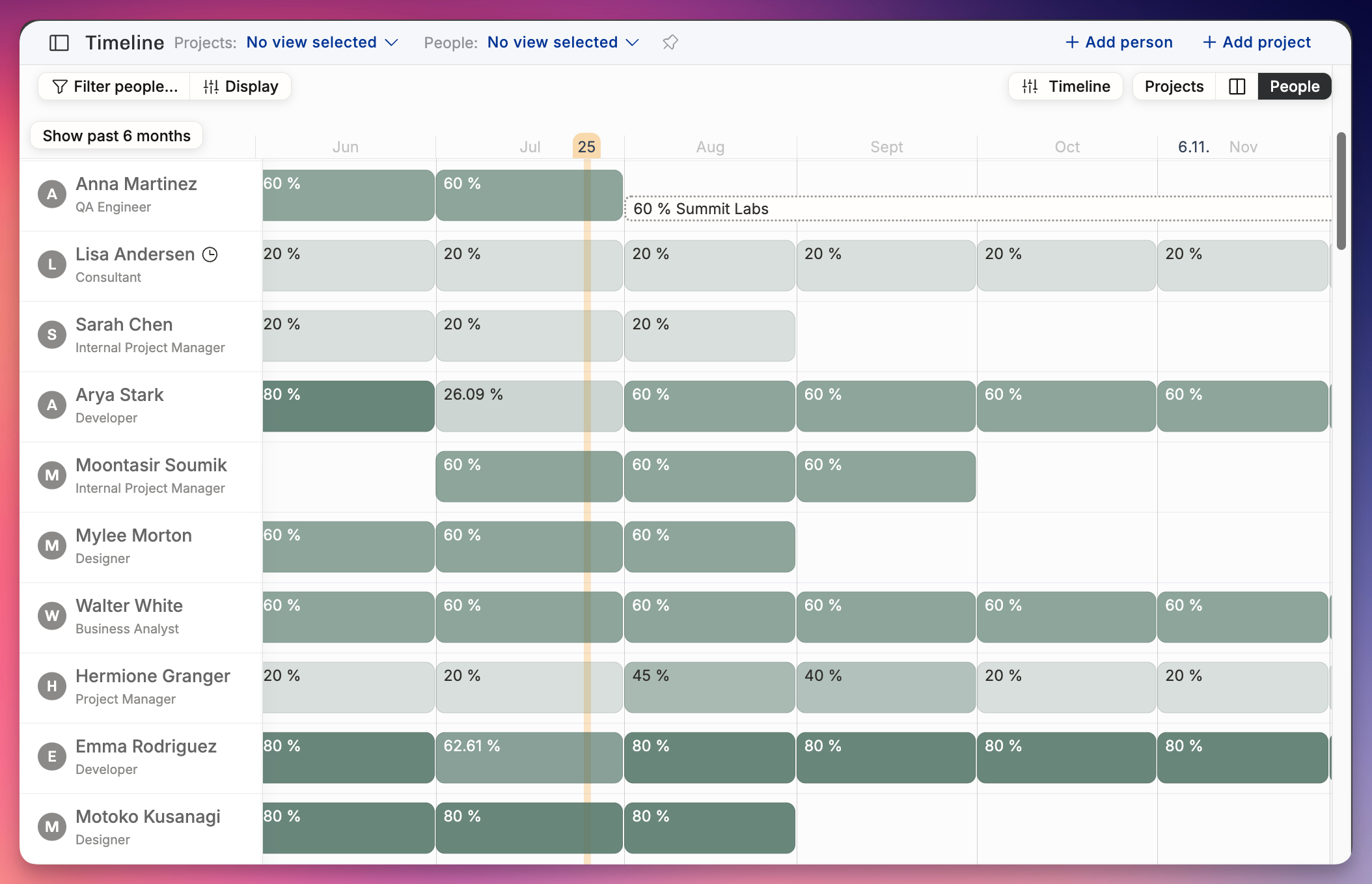

Allocations on a timeline

Each person has a summary row showing a high-level view of their positions and allocations.

  • Confirmed allocations – solid green bars

  • Tentative allocations – outlined with grey diagonal lines

  • Overallocations – red underline (more than 100%)

  • Time off – dark brown blocks

  • Public holidays – shown as light vertical lines

Click on a person’s name to expand their detailed schedule. Their allocations appear underneath the summary row, which stays visible at the top.

Positions where the person is a candidate

When the person is a candidate on an open position, the expanded schedule shows that position in a candidacy group. The group sits after the person's time off and before their other positions.

  • Group header: reads Candidate for, with the number of candidacies and the note Not counted in allocation. The group is closed by default. Click the header to open or close it. While the group is closed, the header row shows the candidacies' allocations as thin bars, so you can see when they fall.

  • Candidacy rows: when the group is open, each candidacy has its own row, sorted by project. A Candidate tag with a bookmark icon marks the row, and the row shows the open position's allocations as bars.

Candidate bars don't count toward the person's load, so they add nothing to the summary row.

The candidate row on the person's expanded timeline

Click the project name on a candidate row to open its menu. It has Open project details and Show on project timeline. To add or remove a candidate, use Choose person on the project's Team tab or on the project timeline. See How to find available people for a project.

The Timeline tab on the person's page shows the same rows.

Marcus showing as a potential candidate for the Retailwave Inc. project

How to Add Allocations

Once a person’s schedule is expanded, there are two ways to add a new allocation:

Option 1: Click “+ Add”

  1. Click the + Add button at the bottom of the list of positions on the left hand size to create a new position for the person for a project

  2. Select an existing project or create a new one

  3. Fill in details in the allocation popover (see below)

Option 2: Draw on the Timeline

  1. Hover over a project row or the line to the right of the + Add New button

  2. Click and drag across the dates you want to allocate

  3. Fill in the details in the popover that opens


How to Edit Allocations

Move an allocation: drag it left or right (future allocations only)

Grab an allocation on the timeline and drag it further or to the past manually.

Locked past: You cannot move or edit past allocations to prevent accidental changes to historical data

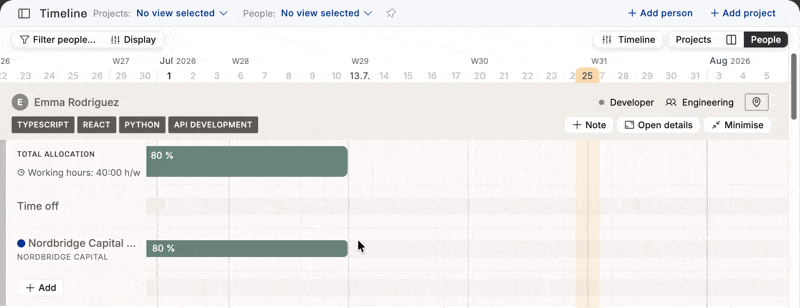

Extend or shorten: drag from the start or end handle

Grab the end or beginning of an allocation and drag the handle to extend or shorten the allocation.

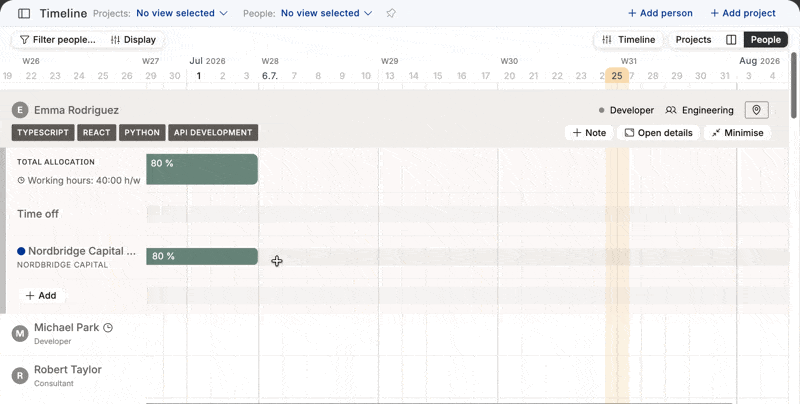

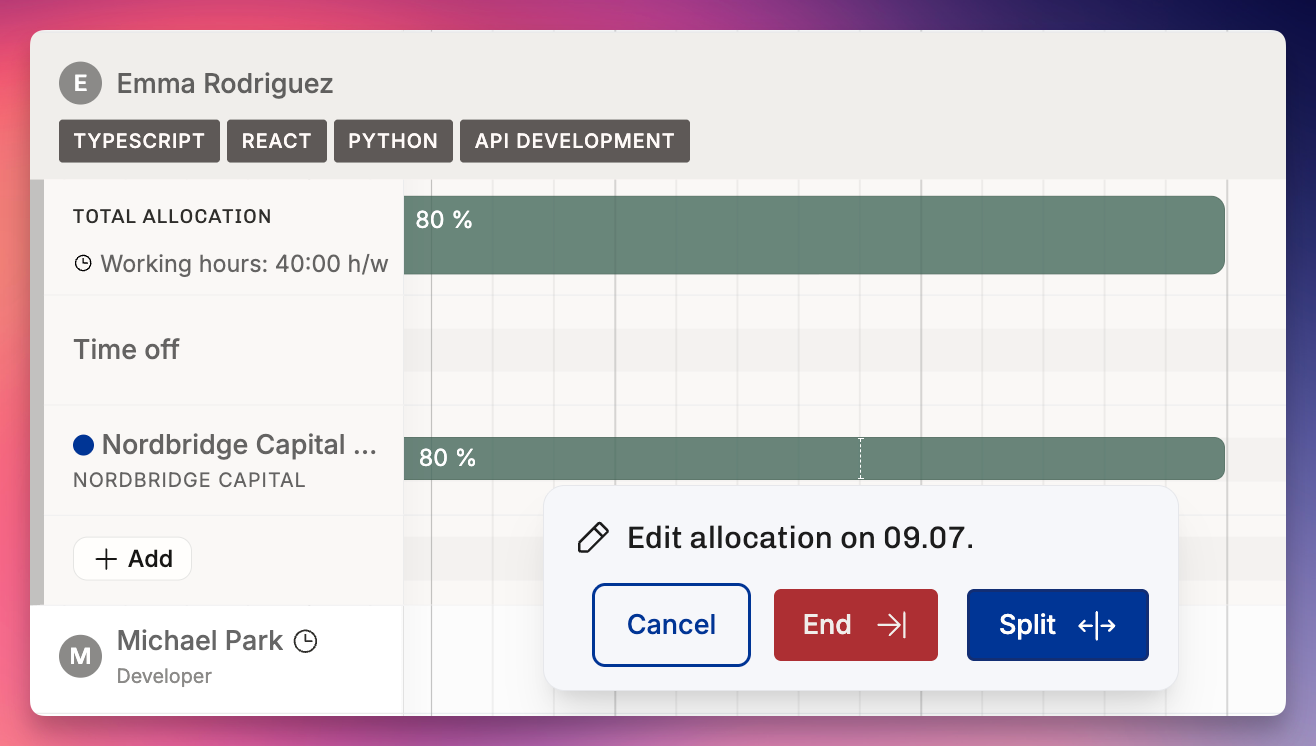

Split an allocation

If you need to split resourcing, for example on a weekly or monthly basis, or when someone’s workload changes, you can split an allocation.

  1. Click the allocation to select it.

  2. Click Split in the toolbar that appears.

  3. Move your pointer over the allocation bar. A dashed vertical line shows where the split will happen.

  4. Click the day where you want to split.

Operating splits the allocation at that date straight away and closes the toolbar.

Splitting an allocation.

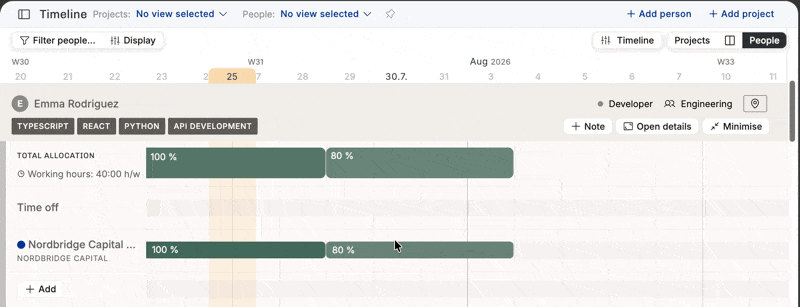

Reschedule entire project on the Timeline

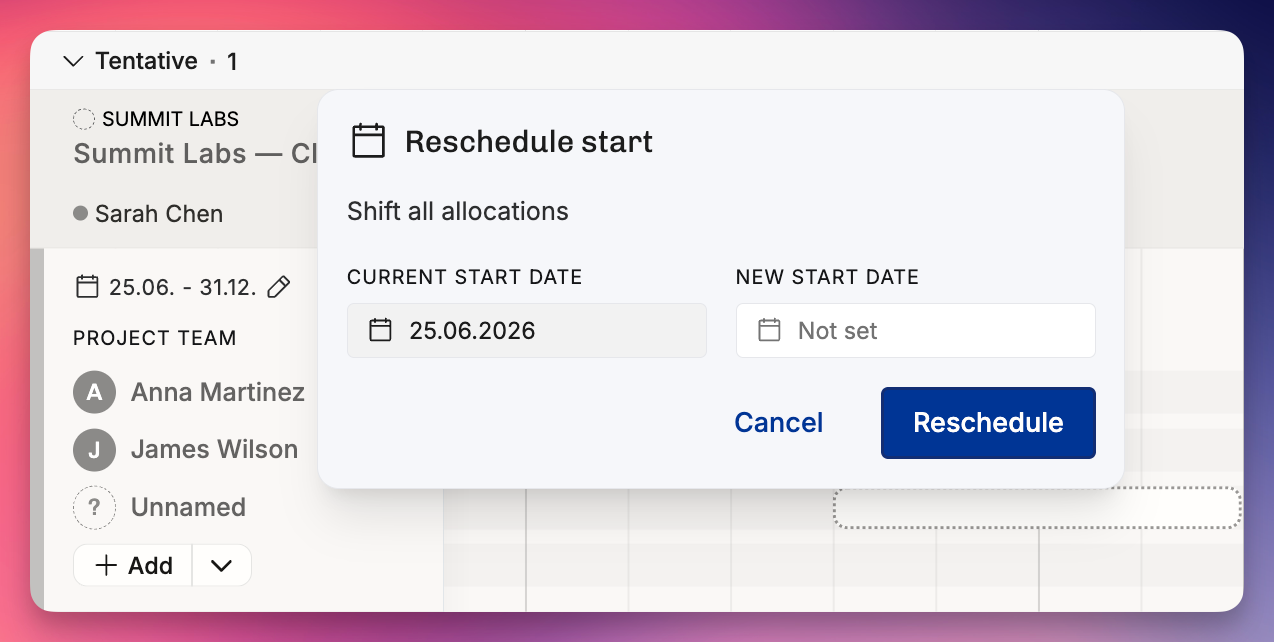

For tentative projects, you can move all the work in one step. Open the project's Timeline tab and click Reschedule in the toolbar above the timeline. Choose the new start date and click Reschedule. The first tentative allocation moves to that date, and the other allocations, the budgets and the phases move by the same number of working days, so the plan keeps its shape.

The reschedule button above the project timeline.

Note: the project status needs to be tentative (unconfirmed) for this to be enabled. You may unconfirm the project, reschedule, and confirm the project again. However, those operations will change the status of each and every work effort in the project.

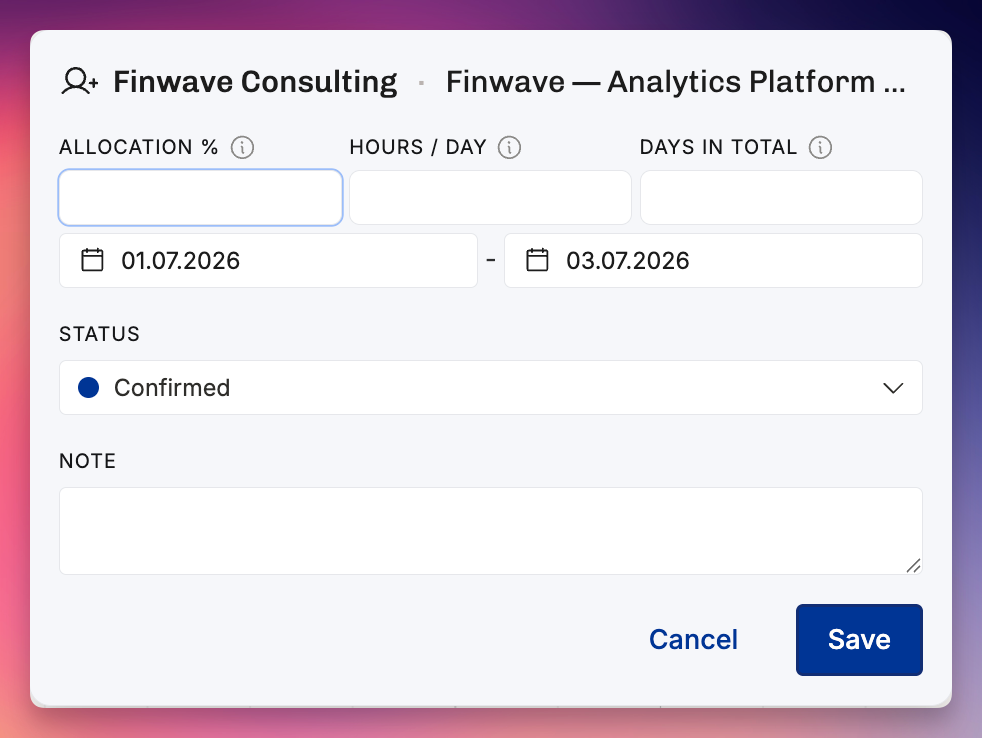

Allocation Popover: What You Can Set

Field

Description

Project (Add to) / Name

The project being allocated to / The Name of the person depending on if you’re on the project or people timeline

Role (Add as)

The position role (if left blank, the primary role of the person is used)

Seniority

The seniority of the position

Allocation %

Percent of the person’s capacity to allocate

Hours / Day

Optional: define allocation by daily hours

Days in Total

Optional: Auto-calculated, or manually entered

Start Date

Start date for the allocation

End Date

End date for the allocation

Status

Tentative or Confirmed

Probability

Set likelihood (useful for planning pipeline work)

Note

Add extra context about the assignment

Note: Only one of Allocation %, Hours / Day, or Days in Total is required. Enter whichever makes the most sense — Operating will calculate the rest.

Popover when creating a new position

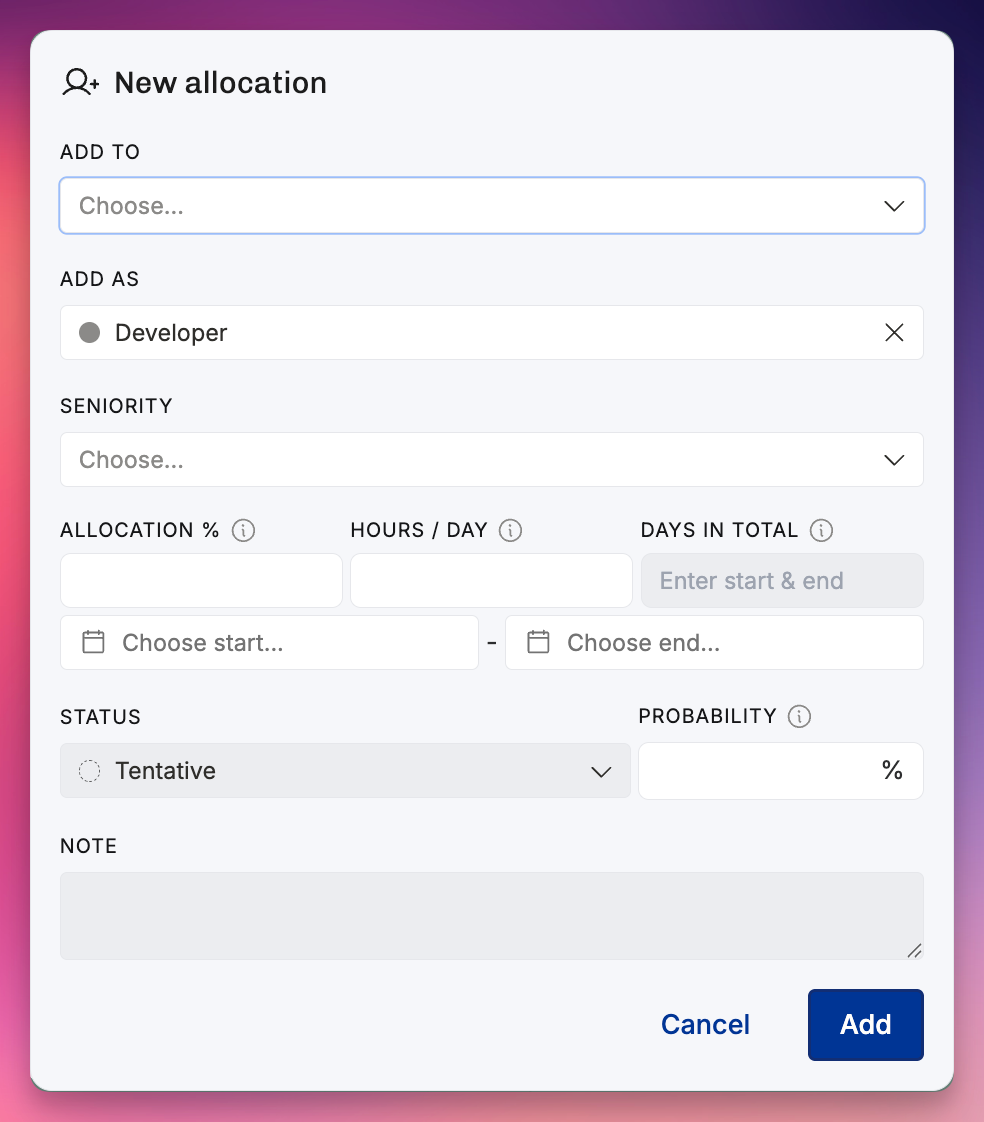

When you create a new position in a project, the popover asks for position details (role, seniority, rate) as well as the first allocation.

Popover when adding an allocation to an existing position

If the position already exists, the popover skips position details and only asks for allocation settings (dates, % or hours, status, etc.).

Click Save to apply the allocation.

Ending or removing a person from a project

How you remove someone depends on the situation:

1. Planned work that never happened (no history to keep):

  • If someone was added but never actually worked on the project — e.g. wrong role, wrong person, or the plan changed — you can delete or archive the position.

  • This removes the position and its allocations from the project.

  • Use this when there’s no meaningful history you need to keep.

2. Someone has worked on the project but is now leaving:

  • Do not delete the position. That would erase historical data.

  • Instead, end their allocation:

    • Drag the end handle of their last allocation to the date they stop working, or

    • Split the allocation at the end date, then select the part after it and click Delete allocation. See Split an allocation above.

  • This keeps the history intact while making sure they no longer appear as allocated after their end date.

3. One person leaves and another takes over:

  • First, end the departing person’s allocation as above in #2.

  • Then create a new position for the incoming person on the project.

  • This way, the record shows Person A worked until date X, and Person B started from date Y.

Flexible Allocation Input

Each allocation can be defined in different ways, depending on how you plan and track work.

When creating or editing an allocation, you can define the workload using whichever input makes the most sense for the context:

  • Allocation % – Use when you want to allocate a share of someone’s daily/weekly availability (e.g. 25% of their time).

  • Hours / Day – Use when planning in average daily effort (e.g. 3 hours per day).

  • Days in Total – Use when allocating a fixed chunk of time (e.g. 20 days total across the timeframe).

You can use any of these inputs — Operating will automatically convert your input into the correct total allocation percentage.

This gives you flexibility to:

  • Allocate ongoing effort (e.g. 25% for the next 6 weeks)

  • Block a daily time commitment (e.g. 3 hours/day)

  • Reserve time for scoped deliverables (e.g. 20 days of work between June 1 and June 30)

Customizing Input Types

In View options, Units when adding and editing sets which units show next to % in the popover: hours per day, week or month, or days per week or month. Total effort unit sets whether the total shows in days or hours.


Adding Time Off Allocations

Everyone has a time off allocation row in their People Timeline. This is used to indicate when someone is unavailable for work — for example, for vacations, leave, or public holidays.

How it works:

  • To view your own time off allocation, click your name on the People Timeline. Your detailed schedule will expand, and the Time Off row will appear.

  • You can draw a time off allocation just like any other allocation: simply click and drag across the dates.

  • When you add a 100% time off allocation, all project allocations underneath it are automatically disregarded for capacity and forecasting. That time is considered unavailable.

  • Partial time off (e.g. 50%) can also be used if you're only away for part of a day or week.

Use cases:

  • Marking upcoming vacation days

  • Blocking out time for leave or personal days

  • Ensuring team capacity forecasts reflect actual availability

If time off is synced from your HR system

If your team has connected an HRIS platform (like HiBob) via a native integration and has chosen to import time off allocations, you won’t be able to edit time off directly in Operating. These allocations are managed in your HR system and kept in sync automatically.


Choose which weekdays the Timeline shows

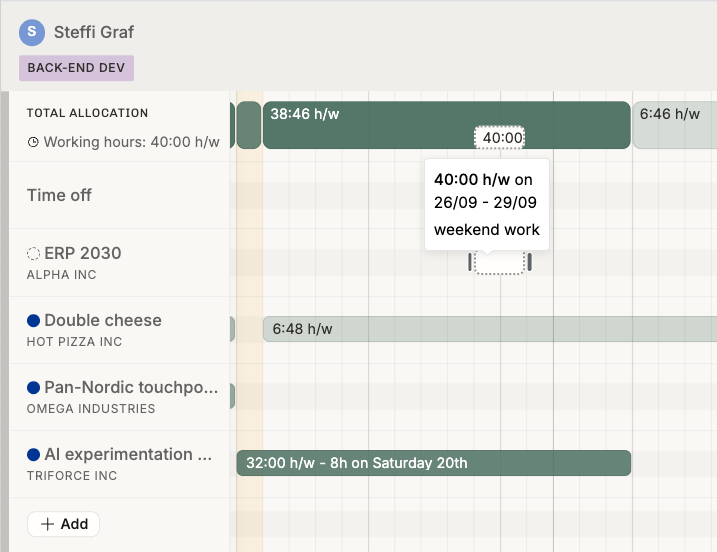

The Timeline shows the weekdays you choose under Visible Days. Click Timeline in the top right corner and turn the days on or off, for example Sat and Sun. Hiding a day only hides its column. Planned time and capacity on that day still count in every figure.

See Timeline layout and settings for the other timeline settings.


Additional Notes & Tips

  • Timeline length & zoom in / out: Use the timeline button next to the people / projects timeline toggle on the top right of the screen the timeline view granularity.

  • TIP: Create a saved view with Person = Me to quickly see only your own schedule at any time.

  • Note: You can only edit your allocations if your admin has granted your user role a permission to do so.


Best Practices

  • Use tentative status for early-stage planning or forecasted assignments

  • Watch summary rows to identify over-allocations or under-utilization

  • Keep past allocations unchanged for historical data integrity
