How to interpret the project details page
In project details, you can make sense of the Project Details Page. It contains multitudes!
Written By Matti Parviainen
Last updated About 4 hours ago
Project Overview

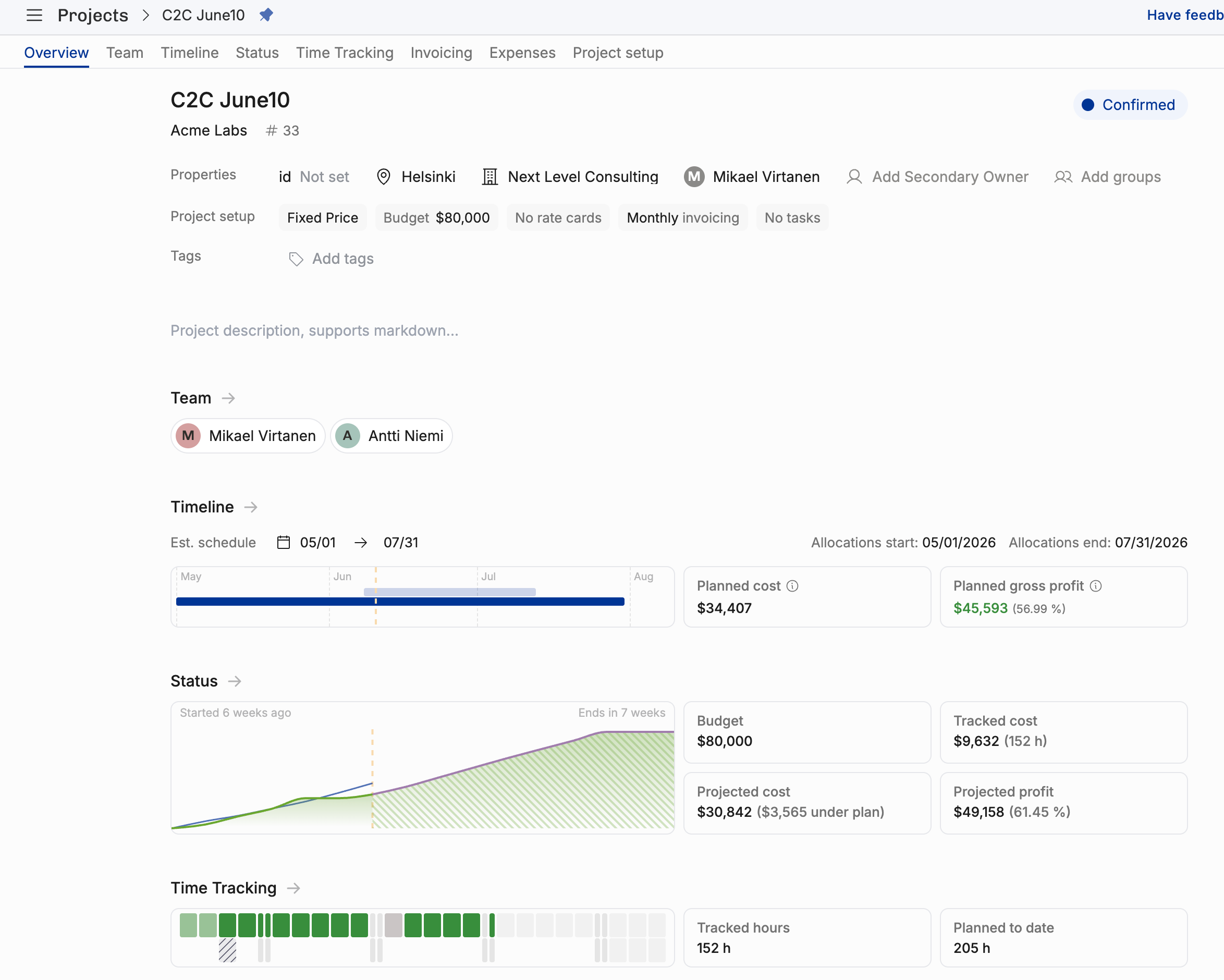

Here’s a project in progress. In the Overview, we can already see some interesting things:

Looking at the Timeline, we can see that the yellow Today-marker is roughly 40% down the project. It’s mostly been 1 person working, but another allocation has been added recently.
If the project has milestones, they show as diamonds above the Timeline, and a list under it shows the next open milestone. See Project milestones.
The Status graph shows the burnup but there’s a slump in with the green line – the tracked time seems to be lagging behind.
That’s exactly what the Time Tracking visualization shows: the green blocks are solid until they’re not.
Near the top of the Overview, a Links row shows the project's CRM deals and the records it is linked to in other systems. A deal shows its pipeline stage and probability, and its value when you can see the project's revenue. Click the deal to see its details. When the project has several deals, the row shows their count, such as 2 deals.
When the project has time entries or expenses dated after tomorrow, a warning box shows near the top of the Overview, on the Timeline tab and on the Status tab. It reads Time entries logged in the future, Expenses logged in the future, or both, followed by They aren't counted as tracked until their date.
The project's tracked hours, costs and revenue count each entry from its own date. If an entry's date is wrong, correct it to clear the warning.

At the bottom of the Overview, Notes holds dated notes about the project, the newest first. Type in Add note... to add one. Each note shows who wrote it and when. When your permissions allow, use the note's menu to Edit or Delete it.
Let’s click on each of these status indicators to learn more…
Team
What’s the resource plan? Who are in the team, are there any open positions?

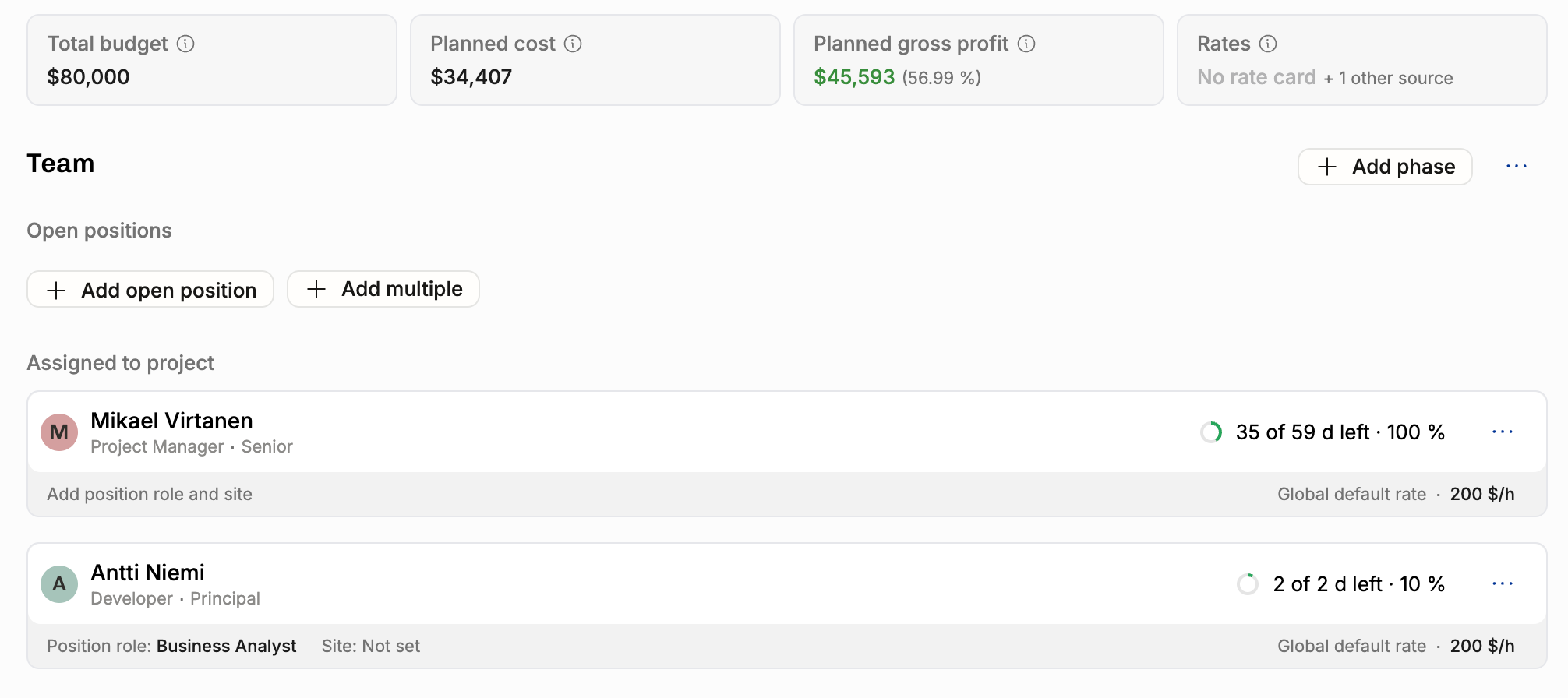

This shows you the team composition on a high level:
Total budget $80k, planned gross profit healthy 56.99%. No rate cards set, but that’s OK, because this is a fixed price engagement.
Two people, Mikael and Antti.
Mikael the project manager working 100%, total of 59 days, 35 days left
Antti, with the role of a business analyst, working 10%, 2 days total

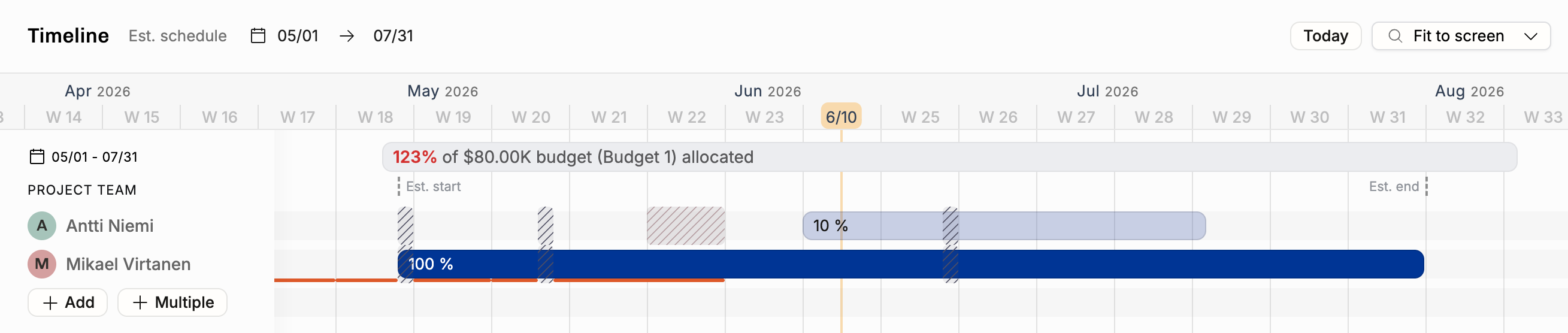

Timeline
Here we’re still looking at the plans (allocations) exclusively:

The timeline shows you that indeed Mikael is the person doing most of the work. Antti recently joined and will do the 10% effort for 2+ weeks. According to the global default rate, each hour is worth $200, and based on that, 123% of the $80k budget has been allocated.
Once the project has milestones, a Milestones band shows them above the rows. Click + Milestone in the toolbar to add one.
Status

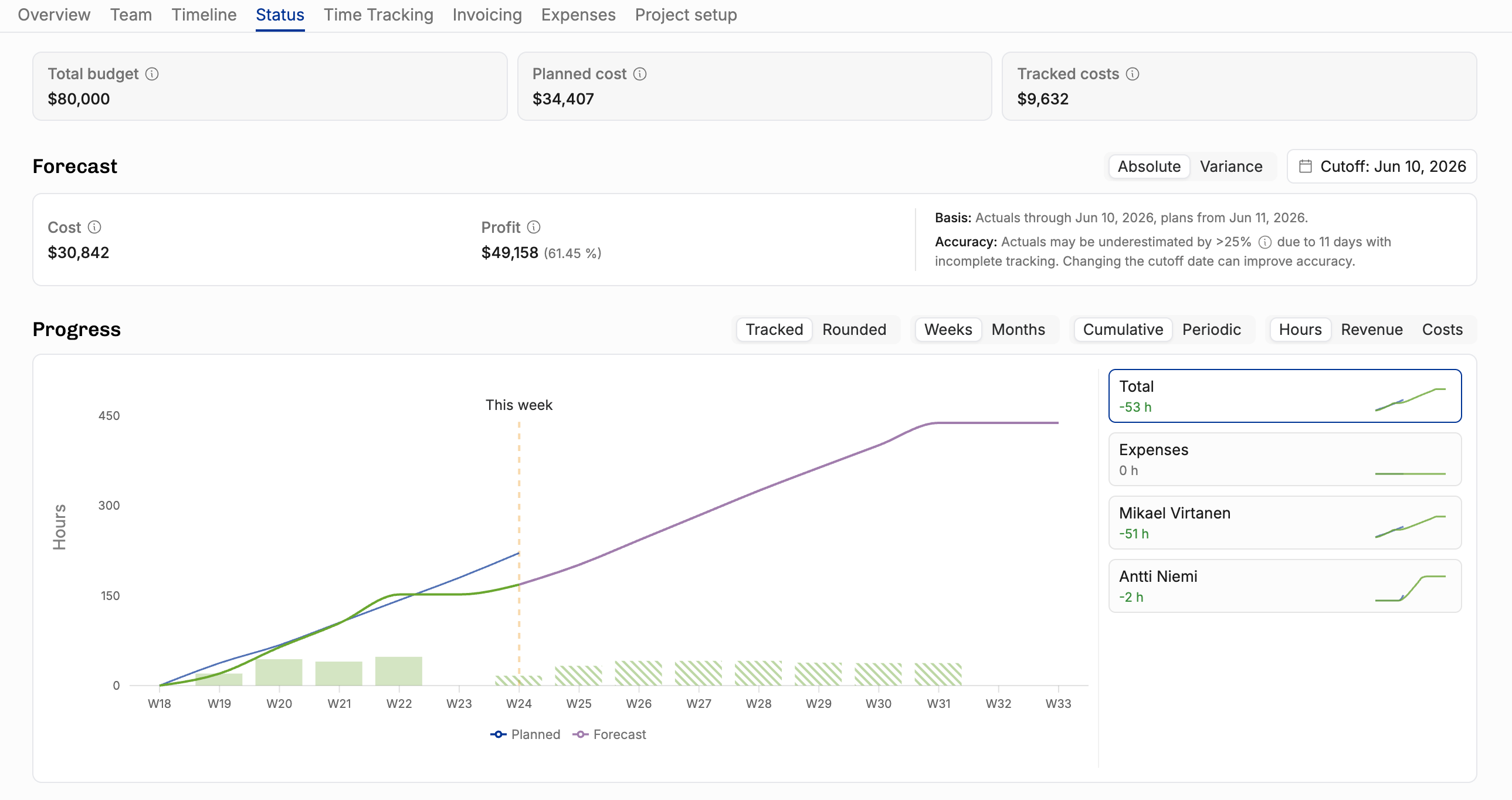

Finally we arrive at the burnup graph that ties it all together: planned and tracked work.

With the cutoff date, you can choose where the forecast begins. The graph uses tracked actuals up to and including the cutoff date, and plans after it. A cutoff date after today counts as today, because actuals stop at today.
When a budget has a target, the graph draws it as a dotted line across the budget's dates. On the Hours graph, the line shows an hours target, or the hours an hourly rate target allows on the budget's amount. On the Costs graph, it shows a cost target, or the cost a margin target allows. The Revenue graph shows no target line.
Hover over the graph to see the target in the tooltip, with how much of it is left or how far the work is over it. On the week-by-week graph, the tooltip shows the pace per week or month instead, which is the target divided by the weeks or months of the budget.
The graph draws targets only when it shows one pricing scope: a project without phases that have their own billing type, or one such phase. When you pick a person in the graph's filter, the line shows that person's hours or cost target on the budget. See How budget targets work.

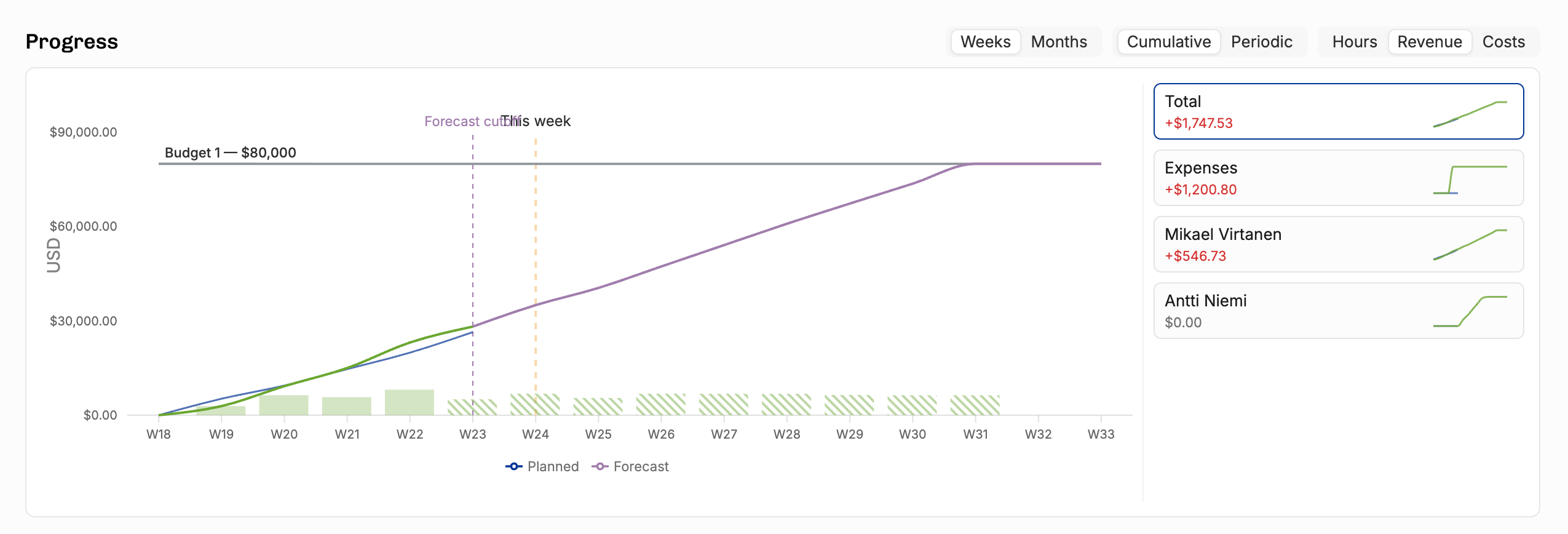

Remember the slump in the green line from the overview? Here it is again. Let’s take a look at the Time Tracking tab just to be sure:

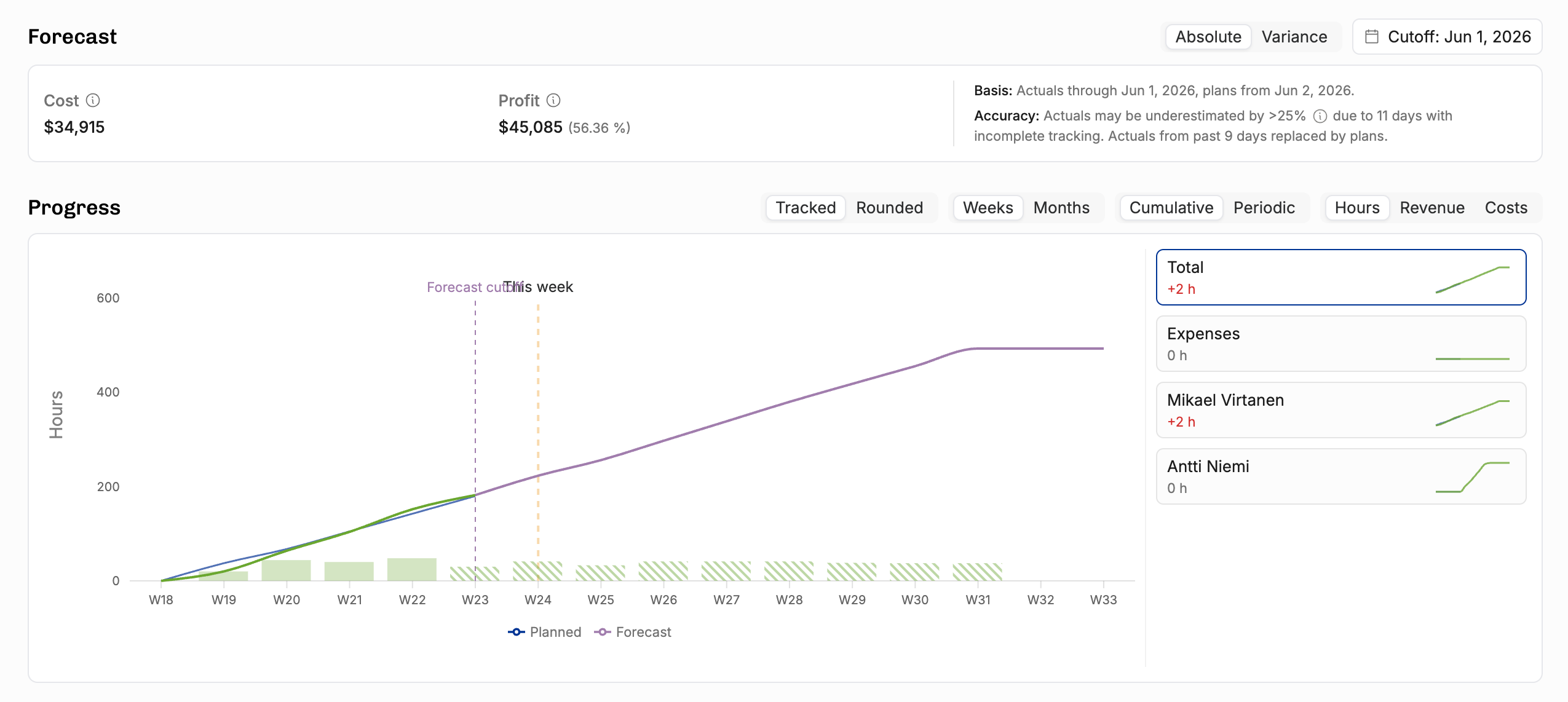

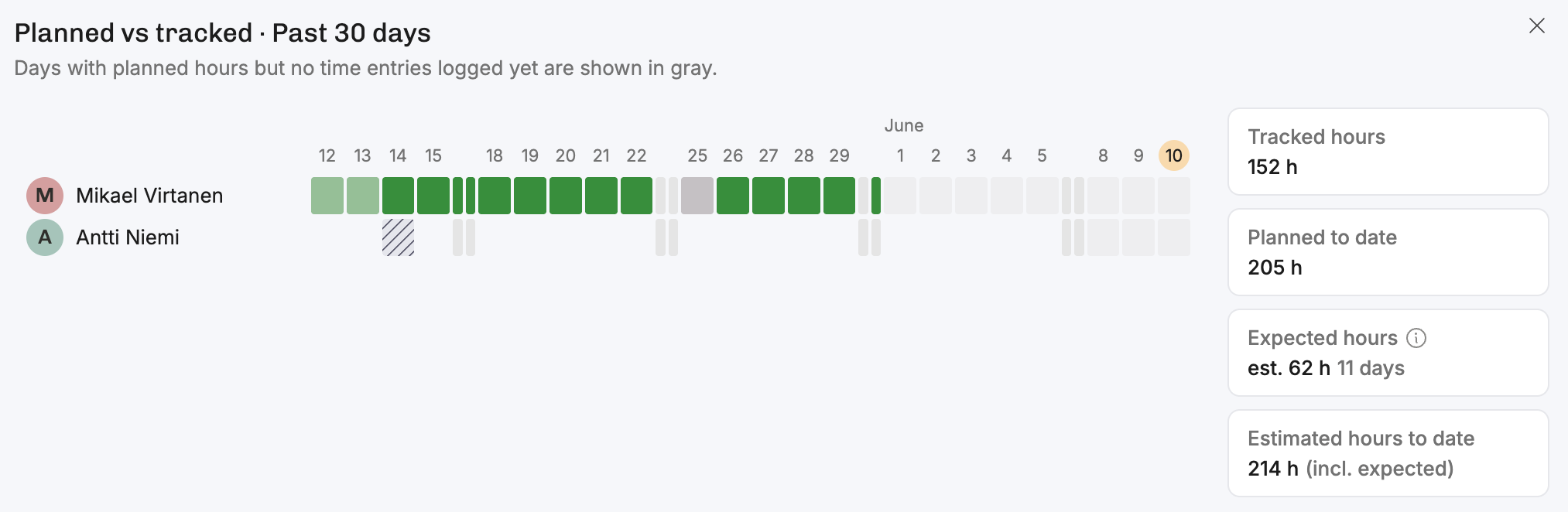

Mikael has time entries until the end of May, but nothing in June. Antti hasn’t tracked anything yet. If we want to understand where the project is likely going to land, let’s move the cutoff date to June 1st to see a smooth curve from actuals to plans.
Cutoff date adjusted

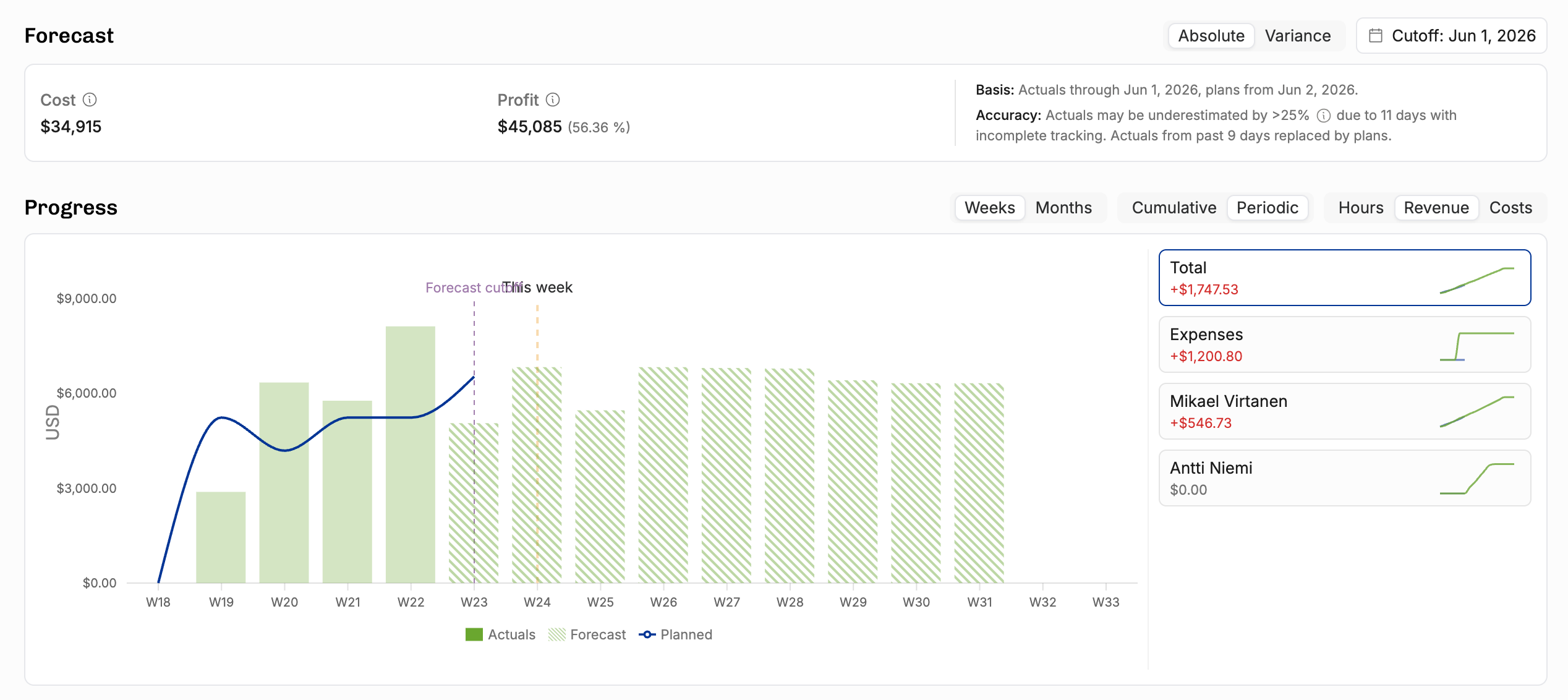

OK, so that’s what’s going on with hours. Let’s change the unit to Costs to see the $500 expense and how it affects the project:

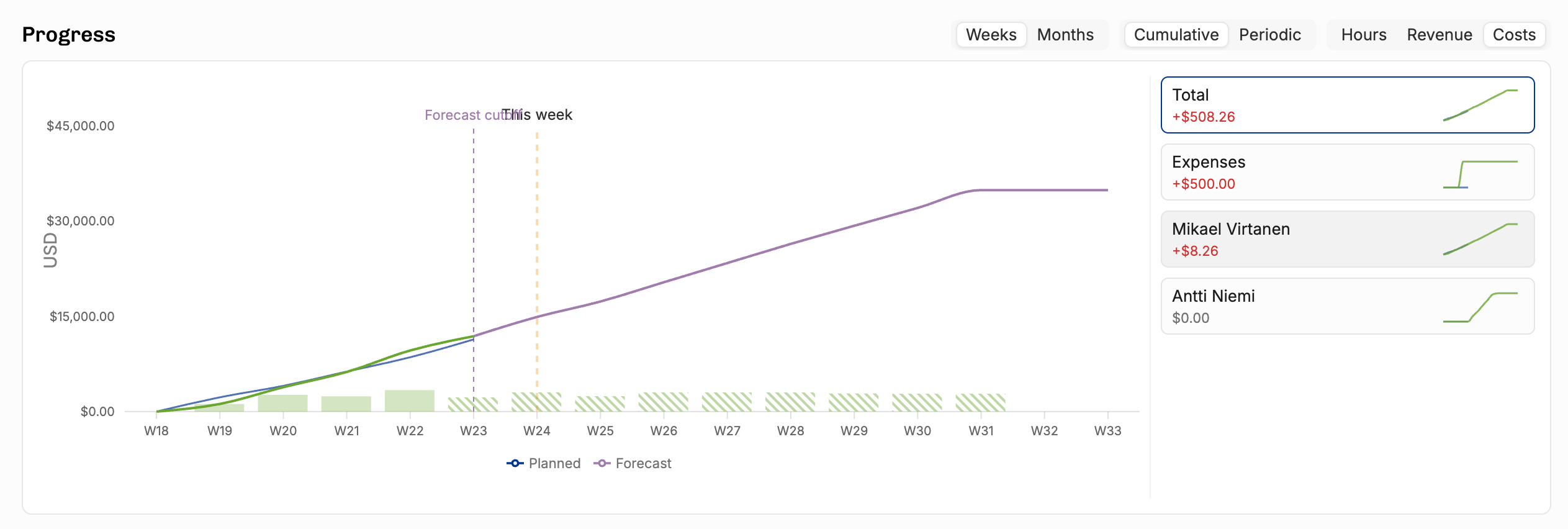

When we change to Revenue, we see the cost-to-cost revenue recognition method in action. The Revenue is attributed to all of the project costs (work or expenses). It’s slightly weird to see the $500 expense be worth $1,200.80, but that’s intentional:

Week by week planned vs tracked
Here’s the same thing periodically week-by-week instead of a cumulative burnup:

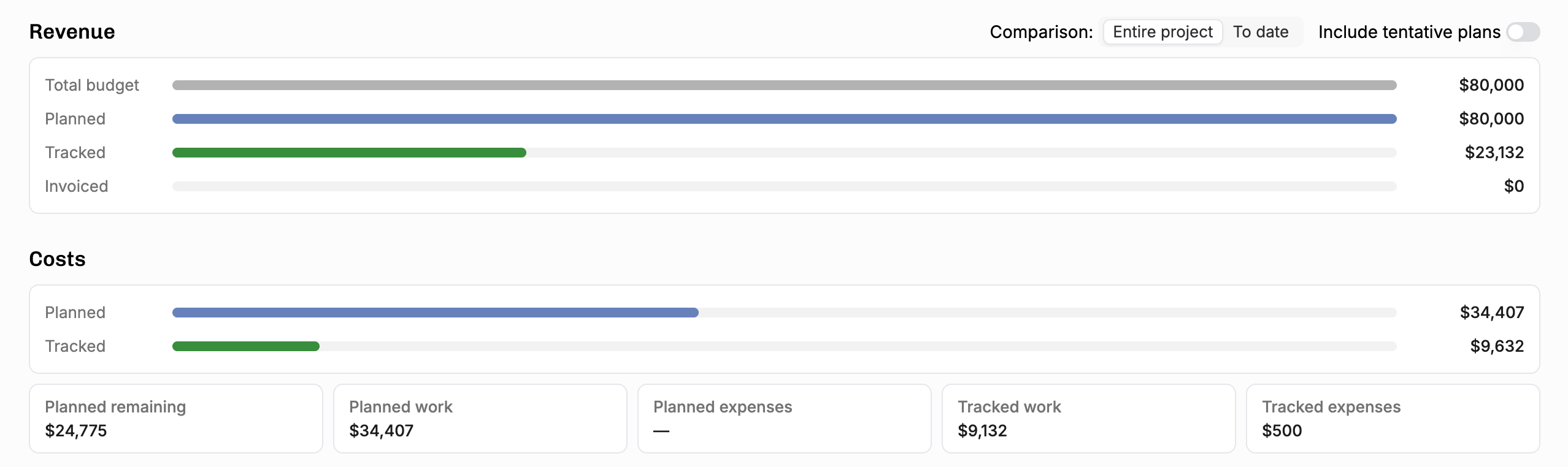

Below the status graphs, you can see the raw numbers used to draw it:

Target progress
When a budget has targets, the Status tab shows a Target progress table below the burnup graph. Each budget's row comes first, followed by its targets for a role, seniority, person or task.
The table has these columns:
Target: the figure you set.
Actual: for hours and cost, the work tracked so far. For margin and hourly rate, the forecast.
Forecast: where the target lands if the plans hold. This column shows for budgets that run today.
Progress: how much of an hours or cost target the actual figure has used.
Status: whether the target holds.
The Status column shows one of these:
Within target: the work is on the right side of the target.
Over target: an hours or cost target is already exceeded.
Below target: a margin or hourly rate target is already missed.
Forecast over target: an hours or cost target holds today, but the forecast goes past it.
Forecast below target: a margin or hourly rate target holds today, but the forecast falls short of it.
Not started: the budget hasn't started yet.
The table lists the budgets that run today. When the project has other budgets with targets, turn on Show all budgets to see them too. See How budget targets work.

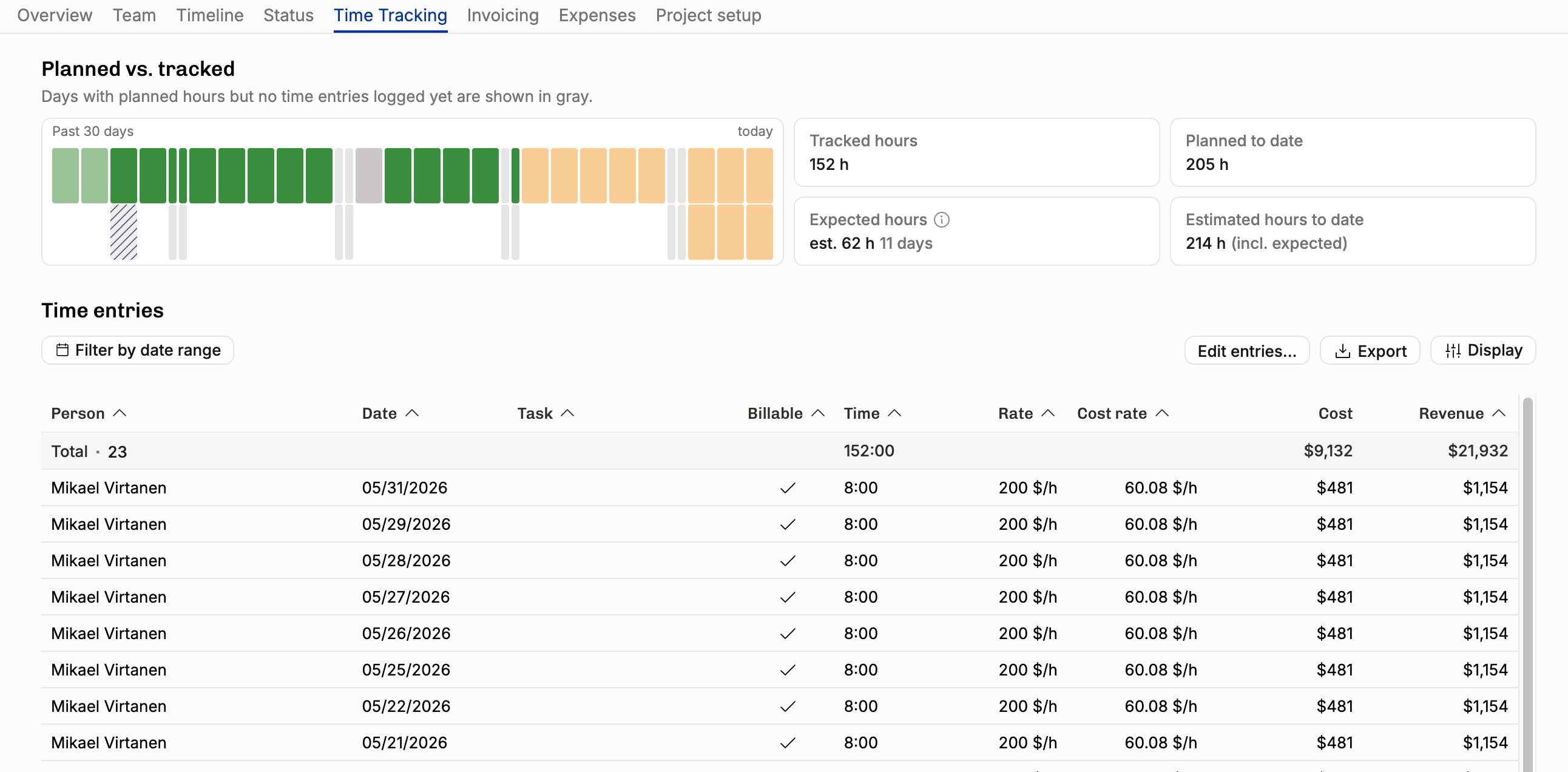

Time tracking

Hovering over the Expected hours, we see the yellow highlight on the days where the team has plans but nothing tracked yet.
Below, you can see a table of all of the time entries tracked in this project, all time. Filter by date range to see e.g. monthly totals. Use the Display menu to group the data as you like!
Invoicing
The Invoicing tab lists the project's invoices. It shows when your organization uses invoicing, and you see the invoices when you can read invoices or when you are the project's invoice owner. When the project has no invoicing schedule and no invoices, the tab shows No invoicing schedule set. If you can edit the project, click Add invoicing schedule to set one up. See How to create and send an invoice.
Expenses
The Expenses tab sums up the project's expenses and lists them. When the project uses planned expenses, the tab lists those too. The tab shows when your organization uses expenses and you can see or add expenses on the project. See Understanding expenses in Operating.
Revenue Recognition
The Revenue Recognition tab shows how much revenue the project recognizes, month by month. Click a month to see its details. The tab is available on request: email support@operating.app to turn it on for your organization. Once it is on, you see the tab when you have permission to view revenue on the project. Non-billable projects do not have it. See How revenue recognition works in Operating.
Project setup
The Project setup tab holds the project's settings: the currency and rate cards, the billing type and budgets, time tracking, the invoicing schedule and Advanced features. You see the currency, rate cards and budgets when you can see the project's revenue. Under Advanced features, you choose which project features this project uses. See How to turn project features on or off.
